Bulk Documentation
WorkflowsQuality and compliance

Manage safety risk

Run the safety-risk cycle in Bulk: score hazards on the risk matrix, control them with approved measures, investigate incidents, and run pre-use checks.

Last updated

Managing safety risk is the ongoing work of finding what could hurt someone on the shop floor, deciding how serious it is, putting controls in place, and learning from anything that goes wrong. Bulk brings that whole cycle into one place, the Safety module, so hazards, controls, incidents, and equipment checks live together instead of in scattered spreadsheets and paper folders.

This is a workflow page. It explains how the pieces of Safety fit together and, at each step, links to the focused task article that walks you through the details. Read it top to bottom to understand the full cycle, or jump to the stage you need.

Bulk supports your safety process

The Safety module helps you record, score, and track risk, but it is a management tool, not a substitute for your workplace's safety procedures, training, or legal duties. In an emergency, follow your site's emergency procedures, never a screen. Treat any risk score or status in Bulk as an input to a competent person's judgement, not the final word.

What managing safety risk covers

Bulk splits safety work into four connected areas, each with its own page in the Safety module:

  • Risk Assessments, record a hazard tied to a task or area, score how risky it is, and list the measures (the controls) that reduce it. A hazard is anything with the potential to cause harm; a measure is a control you put in place, such as a guard, a procedure, or protective equipment.
  • Risk Matrix, see all your assessments plotted by how likely harm is against how severe it would be, so you can spot where the biggest risks sit.
  • Incidents, report, investigate, and close out things that actually happened, including near misses (events that could have caused harm but did not).
  • Asset Readiness, track the pre-use checks that confirm each machine is safe to run. An asset is a machine or piece of equipment; a pre-use check is the inspection an operator completes before using it.

The Safety home page pulls these together into a summary strip, Risk Overview, Pending Approvals and Pre-use Checks. The current desktop layout places the checks below the first two widgets.

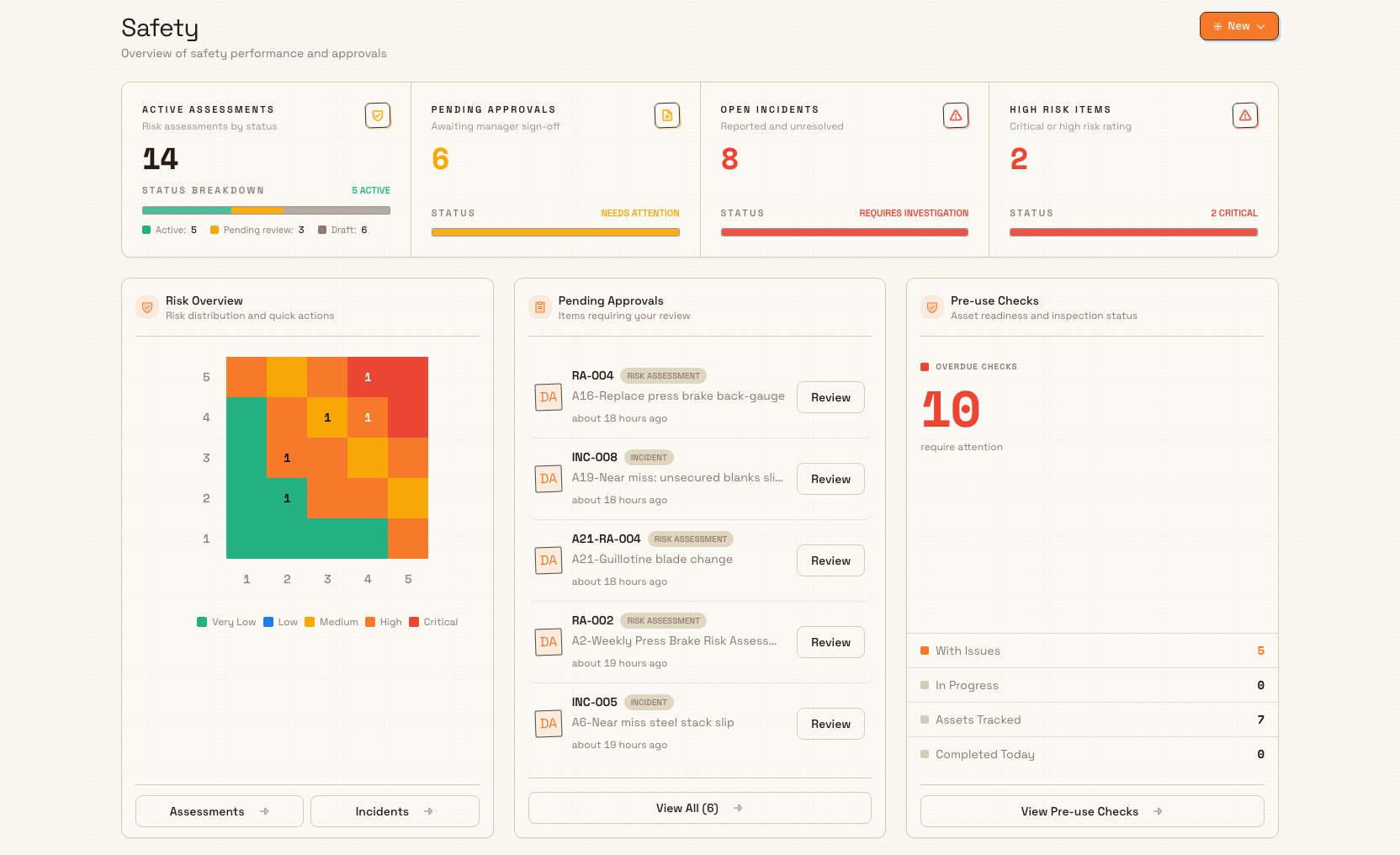

Safety home showing its four summary tiles, populated risk grid, three named pending incident approvals and the full pre-use-check status card.
Safety home connects assessment status, pending approvals, incidents and pre-use checks in one overview.

Before you begin

To work in Safety you need to be signed in and working in a plant (Bulk also calls a plant a site or entity, a single factory or workshop). See Getting started.

What you can do in Safety depends on your role and its permissions. Bulk uses granular safety permissions, and a role can hold some without the others:

  • View safety lets you open the Safety module and read assessments, incidents, and readiness.
  • Create risk assessments lets you add and edit assessments and their measures.
  • Approve risk assessments lets you approve or refuse an assessment so it becomes Active.
  • Create incidents lets you report and edit incidents.
  • Approve incidents lets you approve or refuse a reported incident.
  • Manage types lets you configure incident types and safety settings.

Several built-in roles carry the full set, Super user, Entity admin, Manager, and the dedicated Safety role. If you can open Safety but a button such as New Assessment or an approval action is missing, you likely hold view access without the matching create or approve permission; ask an administrator to adjust your role. Administrators can review the safety roles and settings in Safety types and settings.

Assess and control workplace risk

Risk assessment is the heart of the cycle. Open Safety › Risk Assessments to see every assessment in a table with its Document ID, Task Name, Status, Risk Level, and number of Measures. Select New Assessment to start one.

An assessment moves through clear statuses:

  • Draft, you are still building it.
  • Pending Approval, submitted and waiting for a reviewer.
  • Active, approved and in force.
  • Archived, retired and kept for the record.
  • Refused, a reviewer sent it back.

You score each risk two ways, once for the raw hazard and again for the residual risk that remains after your measures, using likelihood (how likely harm is, rated 1 to 5) multiplied by severity (how bad it would be, rated 1 to 5). That product, from 1 to 25, sets the Risk Level:

  • Critical (20 to 25), immediate action required.
  • High (15 to 19), senior management attention needed.
  • Medium (10 to 14), management responsibility.
  • Low (5 to 9), manage by routine procedures.
  • Very Low (under 5), acceptable risk level.

The Risk Matrix page defaults to Active only; use its status filter to include other assessments. It plots the selected assessments on this five-by-five grid so you can see, at a glance, where your most serious risks cluster and which need attention first. Select a populated cell to see its likelihood, severity, total, risk level and named assessments. This shared scoring language keeps every assessment comparable across the plant.

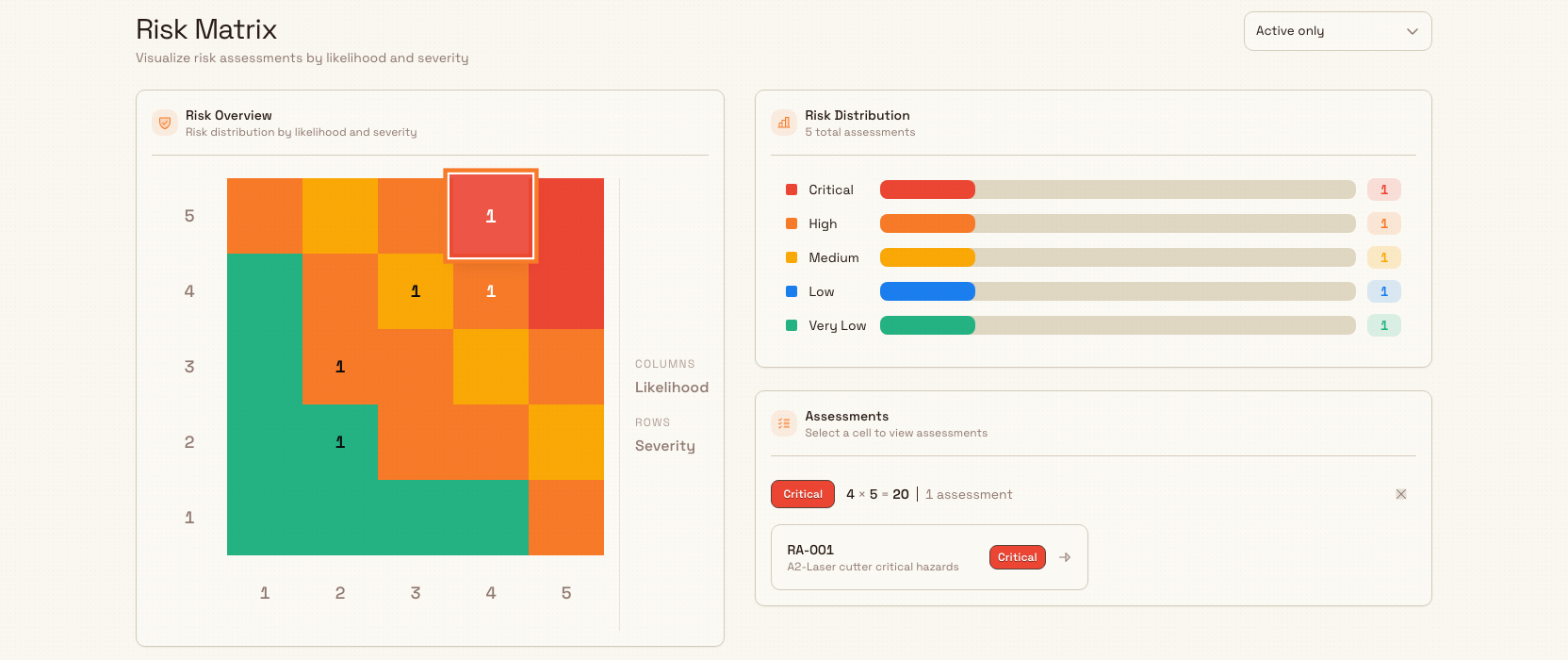

Five-by-five risk matrix with four active assessments, risk distribution and the selected High score15 cell containing Overhead Crane Isolation.
Select a populated cell to see its assessments. Here likelihood3 times severity5 gives15, High, for Overhead Crane Isolation.

Along the way Bulk helps you keep assessments complete and current:

Respond to incidents

When something happens, an injury, damage, or a near miss, record it under Safety › Incidents (titled Incident Reporting). The table lists each incident by Incident #, Title, Type, Location, Status, Reported By, and Date. Select New Report to start one.

An incident works through its own lifecycle: Draft while you write it up, Awaiting Approval once submitted, then Approved or Refused by a reviewer, and finally Closed when the follow-up is complete. Reporting captures the details and evidence; investigation records what you learned and the actions you are taking, grouped as Immediate Actions, Preventive Measures, and System Changes, and closing confirms the work is done.

Follow the task guides for each stage:

Incidents feed back into assessments: a near miss on a machine is a strong signal to revisit that machine's risk assessment and tighten its measures.

Keep equipment safe to use

Controls only work if the equipment is fit to run. Safety › Asset Readiness shows the pre-use check status for each asset, Not Started, In Progress, Completed, Due, or Expired, and each completed check records a result of Passed, Failed, or Passed with Issues. A check that is overdue or failed can block work at a workstation until it is resolved, which keeps an unsafe machine from being run by mistake.

For the detail, see Track asset readiness and Read pre-use check results. The pre-use checks themselves are built as audits, so administrators set them up alongside your other audit programs, see Run a compliance audit program.

A worked example at Gotham

For an illustrative workflow, Bruce Wayne could manage the records for a new hydraulic press brake at Gotham Applied Sciences, part of Wayne Enterprises. The controls and scores in this example explain the record flow; they were not created or approved for the pictures.

  1. Assess. Create an assessment for Operating the No. 3 press brake. Review the hazards and score their likelihood and severity. A likelihood 4 and severity 5 rating gives 20, Critical.
  2. Control. Record the measures chosen through the plant's safety process, then score the residual risk. Submit the completed assessment for an authorized review so it can become Active.
  3. Watch the portfolio. Use Risk Matrix to see the active assessments by score, select a populated cell and review the work recorded there.
  4. Learn from a near miss. Record an actual near miss under Incident Reporting, investigate it and revisit the relevant assessment and measures.
  5. Keep checks current. Use Asset Readiness to identify due checks and follow the plant's configured inspection and readiness process before running the machine.

The assessment, incident follow-up and equipment checks remain connected to the same plant records.

Expected result

Once you are using Safety to manage risk, you can:

  • record every hazard as a risk assessment, score it by likelihood and severity, and control it with measures;
  • read the Risk Matrix to see where your most serious risks sit;
  • move assessments from Draft through Pending Approval to Active, and keep them current with scheduled reviews;
  • report, investigate, and close incidents and near misses, and feed the lessons back into your assessments; and
  • confirm equipment is safe to run through pre-use checks on the Asset Readiness page.

Feature state and what to expect

The Safety module and everything described here, risk assessments, the risk matrix, incidents, and asset readiness, is generally available and is the standard way to manage safety risk in Bulk.

A few things are worth knowing:

  • Permissions shape what you see. Safety uses separate view, create, approve, and manage permissions, so two people may see different buttons on the same page. A missing action is almost always a permissions matter, not a fault.
  • The Draft Assistant produces suggestions. AI-suggested hazards and measures are a starting point for a competent person to review and edit, never an approved assessment on their own.
  • Pre-use checks are configured as audits. Their templates and schedules live in the Audits and Safety settings, so what appears on Asset Readiness reflects how your plant has set them up.

If something looks wrong

  • The Safety module or a page is missing from your menu. You may not have view safety access, or your plant may not use that area yet. See Understand access and visible navigation.
  • You cannot create or approve. Creating and approving need their own permissions (for example create risk assessments or approve incidents). If those buttons or actions are absent, ask an administrator to adjust your role.
  • An operator cannot start work at a station. An overdue or Failed pre-use check can block a workstation. Open Safety › Asset Readiness, find the asset, and complete or clear the check to unblock it.
  • A risk assessment shows as needing revision. A scheduled review has come due. Open the assessment, complete the review, and update its measures or score so it returns to up to date.
