Bulk Documentation
Product referenceOperationsScheduling

Place or move a job

Put an unplanned job step onto a machine at a chosen time, and move or reschedule placed work, on the Scheduling planning board.

Last updated

The planning board in Scheduling lets you decide which machine runs each job step, and when. "Placing" a step means taking a piece of unplanned work out of the queue and dropping it onto a machine at a specific time. "Moving" means picking up work you already placed and relocating it to a different machine, a different time, or both. Use it when you are laying out the next few days of production, balancing load across machines, or reacting to a rush order that has to jump the queue.

This board is one way to sequence work, not the only way. It places a step on a machine at a time. When you want to rank which step a machine should run next, without setting a clock time, use Prioritisation. Prioritisation is a separate module. It is not another name for this planning board.

A quick vocabulary check, because the board uses these terms throughout:

  • A job is a piece of production work for an order. Each job is made of ordered steps (also called operations), and every step needs one resource; the skill or process it requires, such as welding or laser cutting.
  • A machine (an asset) is the physical station a step runs on. A machine can run a step only when its asset type is set up to allow that step's resource. The board calls these compatible machines.
  • The work queue is the left-hand list of steps that are not yet planned, grouped by order and job.
  • A run (shown as a block on the timeline) is a step once you have placed it on a machine.

This article covers placing and moving individual job steps. For a full tour of the board's panels and controls, see the planning board overview linked at the end.

Before you start

  • You need the Plan jobs permission. Placing, moving, resizing, splitting, merging, and returning work to the queue all require the Plan jobs permission (internally scheduling.plan). By default the Entity admin, Manager, and Operator roles include it. The Tablet user role has only View job planning, so it can open the board and see the plan but cannot change it. If your controls are missing or greyed out, you likely have view-only access.
  • You need at least one compatible machine. If the entity has no machines that can run the queued steps, the board shows an empty state titled No machines to plan on, with guidance to add machines in Settings and allow resources on their asset types. Until a machine is compatible with a step's resource, that step cannot be placed.
  • The board is scoped to the selected site. You plan work for the site (entity) you currently have open. Switch sites first if you need to plan elsewhere.

Gotham planning board with three Fox Assembly steps in the unplanned queue and five asset lanes beside existing Monday work.
Unplanned steps wait in the queue on the left; the timeline shows the machines and work already placed.

Place a job step from the queue

On a large site, the queue loads more jobs automatically in the background. You can work with the cards already shown while Loading more jobs… appears. To jump to work that has not loaded yet, press / and search by order, job, customer, or step. Search uses the whole board and queue, not only the visible cards, and can temporarily show a matching unplanned job at the top when it is beyond the queue's 30,000-job display limit.

There are two ways to place a step. Both snap the start time to the nearest 15-minute point.

Drag and drop

  1. In the Work queue, expand the order and find the step row. The current sheet shows the job, step, operation number, required resource and quantity, according to your Display column choices.
  2. Press and hold the drag handle on the left of the row and drag it onto the timeline. Compatible machine lanes highlight; machines that cannot run the step dim out.
  3. As you move over a lane, a preview block shows exactly where the step will land and how long it will take. The preview turns invalid over a machine that cannot run the step.
  4. Release over a valid lane and time to place the step. It leaves the queue and appears as a block on that machine's lane.

Keyboard

  1. Click a step row in the work queue to focus it, then press Enter. The Plan queue step dialog opens. Space selects or clears a row instead of opening the dialog.
  2. Choose the Machine, the Day, and the Start time. Only compatible machines appear in the list; if none do, the dialog shows No compatible machines are available.
  3. Select Plan step to place it.

Faster planning

You do not have to drag. Focus any queue row and press Enter to place it from the keyboard, and press the / key anywhere on the board to open Find job or step and jump straight to a specific job.

Unsaved Plan queue step dialog for QQW6 on Coupling Inspection Bench at 10:00 on Monday 5 October.
Review the compatible machine, day and start time before selecting Plan step.

Move or reschedule placed work

Once a step is a block on the timeline, you can move it as often as you need.

Drag to a new slot; Drag the block to another time on the same lane, or to a different machine lane. The same compatibility highlighting and 15-minute snapping apply. Dropping it commits the move immediately.

Use the block menu; Right-click a block (or focus it and press Shift+F10) to open its menu. From here you can:

  • Move to time…; opens a dialog to set the machine, day, start time, and duration precisely, then select Save move.
  • Move to machine; shows the machine the block is on now (labelled current), then other compatible machines with their load. When the list is long, search by machine name. Picking a destination keeps the current start time and just changes lane.
  • Return to queue; unplaces the step and sends it back to the work queue, without losing it.
  • Find job in queue; jumps to the step's job in the queue.

Every placement and move saves the moment you make it, and the board updates live for everyone planning at the same time.

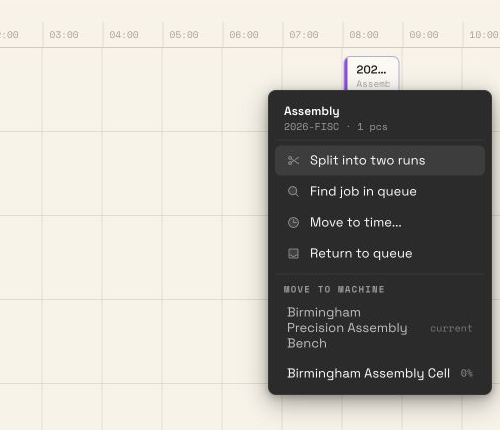

QQW6 planned block with move and return actions, current Coupling Inspection Bench and compatible Gotham Assembly Cell at 4% load.
The block menu shows move actions, the current machine and compatible destinations.

Example: planning Fox coupling inspection

At Gotham Applied Sciences, Fox Precision order 2026-PRD-09A contains 2026-QQW6, a one-piece coupling job with an Assembly step. Its compatible owned workstation is FOX-Q1 / Coupling Inspection Bench.

The planner focuses the unplanned row and presses Enter. They select the bench, Monday 5 October and 10:00, then review the filled dialog. Selecting Plan step places the estimated one-hour run at 10:00 to 11:00.

The placed block's Move to machine submenu marks Coupling Inspection Bench as current and lists Gotham Assembly Cell at 4% daily load. Opening this menu does not move anything. If the plan is no longer needed, Return to queue makes the same step available for planning again.

When a slot already has work: planning batches

The board does not stop you from placing two steps over each other on the same machine; overlaps are allowed and simply flagged. A block that overlaps other work shows overlaps.

When you drop a step onto a time that overlaps existing work on the same machine, the board offers a Planning batch; a group of steps that share one machine and start time and then move together as a unit. A dialog appears explaining that the time overlaps planned work on the same machine, and offers three choices:

  • Create batch or Add to batch; group the steps so they run together and move as one.
  • Plan separately; place the step at the dropped time anyway, overlapping the existing work.
  • Cancel; do nothing.

Adjust how long a step takes

Each queued step gets its planned duration from the cycles set up on its process: the timer goal plus the OEE target of every active cycle, added together and rounded up to the next 15 minutes. A step whose process has no active cycles is planned for one hour. When a step is planned cycle by cycle, each cycle block uses that cycle's own timer goal plus OEE target. After a step is placed, you can drag the right edge of its block to change how long it takes; the new duration snaps to 15 minutes. To undo an override and go back to the system's figure, right-click the block and choose Reset to estimate.

What planning does not do

The plan is not the shop floor

Place and move work manually using the queue, keyboard dialog and timeline controls. The current header has day navigation, zoom, Find and Display controls; it does not show an Auto-plan button. Placing or moving a step arranges the plan. It does not by itself start production or change a job's live machine assignment. Production picks up the planned work as its own step.

Troubleshooting

  • A machine will not accept a step, or you see "This machine cannot run this step". The machine's asset type does not allow that step's resource, so it is not compatible. Drop onto a highlighted lane instead, or have an administrator allow the resource on that asset type in Settings.
  • You see "This machine is unavailable right now". The machine is in maintenance or offline. The board marks it as Unavailable and it will not take new work until it is back. Choose another machine.
  • You see "This step was already planned" or "This step is already split". Someone else changed that step while you were working. The board refreshes on its own; find the step in its new position and continue from there.
  • The keyboard dialog says "No compatible machines are available". No machine in this site can run the step's resource. Add or configure a compatible machine before planning the step.
  • The queue stops at "Showing the first … jobs". The scrollable queue has reached its 30,000-job display limit. Use Find job or step to reach the rest.
